Pattern Energy

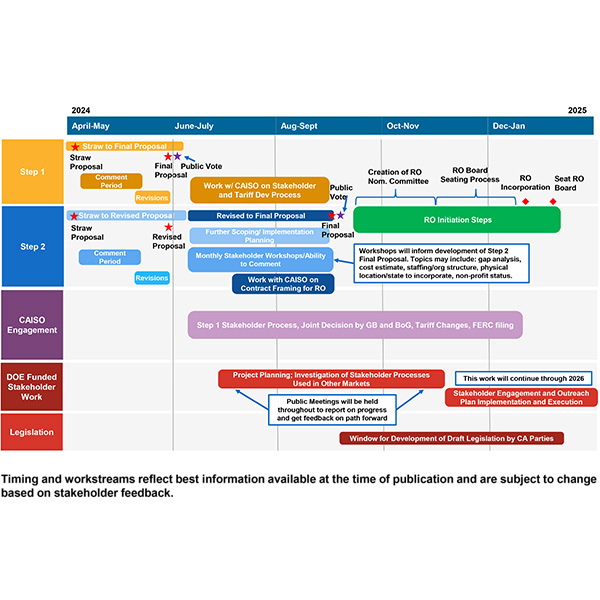

The West-Wide Governance Pathways Initiative applied for the money in January in response to a DOE Funding Opportunity Announcement, seeking two tranches of $400,000 each to be disbursed over two years to help support the effort build an independent Western RTO.
Backers of an initiative to create an independent Western RTO that builds on CAISO’s markets have floated a plan to untangle the snag that’s hung up past efforts to “regionalize” the ISO: a lack of independent governance.
CERAWeek 2024 by S&P Global was supposed to explore “strategies for a multidimensional, multispeed and multifuel energy transition.” Instead, the buzz was all about data centers and artificial intelligence.
FERC approved an open access transmission tariff for the SunZia HVDC line in the Southwest, which will govern how the merchant project can sell any additional capacity it has going forward.
Transmission developers discussed the obstacles to getting their projects permitted and built, but also focused on successes, with a strong focus on community and stakeholder engagement.
The clean energy industry has incentives in the Inflation Reduction Act but lacks ambition, the head of the Department of Energy’s Loan Programs Office said.
The BLM’s record of decision for Pattern Energy’s SunZia transmission line was also the final major approval needed for SouthWestern Power Group’s RioSol line.
BLM approves SunZia project, which will send wind power from New Mexico to Arizona for customers there and in California.
Arizona regulators granted a key approval to the SunZia Transmission project, which would deliver wind energy from central New Mexico into Arizona.
A Western RTO will be necessary to build the kind of grid needed to meet states' GHG goals, according to speakers on a panel hosted by ACEG.
